Free Lien Waiver Form Template
Understand conditional, unconditional, partial and final waivers. Build your lien waiver form in minutes with Document Genius's step-by-step questionnaire.
- Download as PDF and Word
- E-sign included
Monday - Friday 9AM – 6PM EST
Understand conditional, unconditional, partial and final waivers. Build your lien waiver form in minutes with Document Genius's step-by-step questionnaire.
Choose the state or form type you need to start.
Answer a few simple questions to customize your form.
Download or print your custom document in PDF or Word.
A lien waiver form is a document in which a contractor, subcontractor, or supplier gives up their right to place a lien on a property in exchange for payment, or confirms they have already been paid.
Construction work in many places carries a right to claim against the property itself when someone is not paid. A lien waiver is how that right is given up, usually as part of the payment process.
Property owners and general contractors ask for them routinely. Collecting waivers as payments are made is how they establish that everyone down the chain has been paid and that no claim is hanging over the property.
The form matters because signing one can genuinely extinguish a right to be paid through the property. It is a legal document rather than a receipt, and it should be treated as one.
Waivers are usually described along two axes, and confusing them is where people get hurt.
These take effect only if payment actually clears. If the cheque bounces or the transfer fails, the right survives.
These take effect on signing, regardless of whether payment arrives. Signing one before the money is in your account means giving up the right with nothing to show for it.
These cover work or amounts up to a stated date or progress payment, leaving later work unaffected.
These cover the entire project and are given when the last payment is made.
The safest combination for someone waiting to be paid is a conditional partial waiver during the project and a conditional final waiver at the end. Anyone asking you to sign an unconditional waiver before payment has cleared is asking you to take a real risk.
This is the point to take seriously before using any general template.
Construction lien law is set at state level in the United States, and the differences are substantial. Several states prescribe a specific statutory waiver form and treat anything else as ineffective. Others regulate what a waiver may cover, when it may be signed, or whether it can be required in advance.
Deadlines, notice requirements, and who holds lien rights at all also differ, and rules change. What was correct in one state last year may be wrong in another state today.
Because of that, this page does not state any state’s requirements, forms, deadlines, or thresholds. Doing so responsibly is not possible in a general template, and getting it wrong can cost someone the right to be paid.
Before signing or issuing a waiver, confirm what your state requires. A construction attorney in the state where the project sits can tell you which form applies and when. For anything of significant value, that advice is inexpensive next to the exposure.
Subject to whatever form your state requires, a lien waiver form generally covers the same ground.

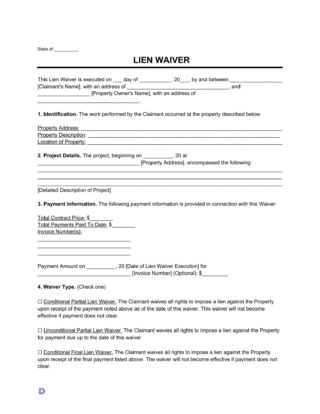

The project name and the property address or legal description.
The claimant giving the waiver, the customer paying, and usually the property owner.
The payment amount the waiver relates to.
The date up to which the waiver applies. This is critical on partial waivers.
An express statement of which this is.
What rights are being given up, and what is expressly excluded, such as retainage or disputed extras.
Any amounts, change orders, or claims specifically carved out.
Signed by someone authorised to bind the claimant.
A few habits protect people on the receiving end of a lien waiver form request.
Read the through date. A waiver dated later than the work it covers can wipe out rights for work you have not been paid for, and this is the most common way money is lost.
Check the amount matches what you are actually receiving. If the figures differ, do not sign until they are reconciled.
List your exceptions. Retainage, pending change orders, and disputed amounts should be excluded expressly rather than assumed to survive.
Prefer conditional over unconditional wherever you can. It costs the payer nothing if they are genuinely paying.
Tip: Keep a copy of every waiver you sign, filed against the project and the payment. On a long job, reconstructing who waived what and through which date is otherwise close to impossible.
A lien waiver form is quick to complete but should be checked before use. Document Genius walks you through each section with simple questions.
Check with a construction attorney or your state’s requirements before adopting any template.
Conditional or unconditional, partial or final.
Use the address and legal description the project documents use.
Both should match the payment being made.
Retainage, change orders, and anything disputed.
Exchange with payment and keep a copy. Start yours now and confirm the form with your attorney before use.
If you are the one collecting waivers, a few things make the process work.
Collect down the chain, not just from your direct contractor. Subcontractors and suppliers may hold rights of their own, and a waiver from the general contractor alone may not protect the property.
Match waivers to payments. Requesting the waiver as part of each payment, rather than chasing afterwards, is what keeps the record complete.
Do not demand unconditional waivers before payment clears. It puts the other party at real risk, it damages the relationship, and in some places it is restricted.
Keep an organised file. On a project of any size, the waiver file is what demonstrates the property is clear.
Nothing on this page is legal advice, and no state’s forms, deadlines, notice requirements, or thresholds are stated anywhere on it. Construction lien law is state-specific and changes; take advice from a construction attorney in the state where the project is located.
